Mayville Sewer & Water | Construction Update 7/22/2024
All plans are dependent on weather; are tentative to change as needed for construction; future updates for major changes to plans/schedule and progress will only be released as needed; You will receive flyer notices as your areas are affected by KPH.
Water main replacement work on 5th St SE and 6th Ave SE will start on July 23, 2024 and is estimated to take 3 weeks. During this time, asphalt and concrete removals will take place along with the replacement of water mains and services. Temporary water may need to be connected to provide temporary service to the home while the water main and service is replaced. Access (driveways) may be limited at times, but will be for a very short period of time.
Tentative Construction Schedule – 7/22/2024
Hydrant/Valve Project
* Area 25: 7/22
* Area 21: 7/29-8/2
* Asphalt reclamation in all sewer and water main replacement areas: 7/18-7/19
Water Main Replacement (South Hwy200)

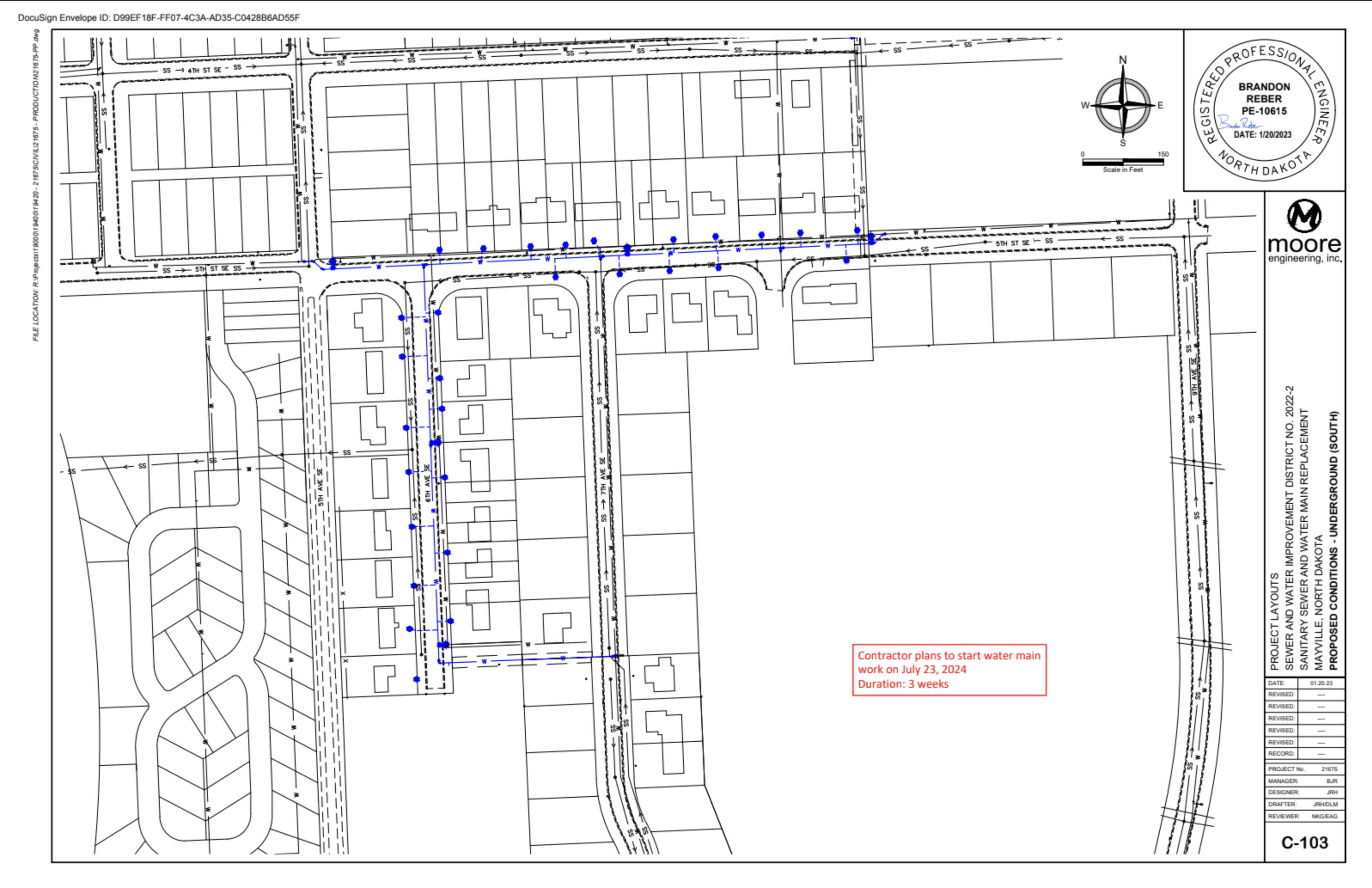

* 5th St SE: 7/23 (3 weeks)
* 6th Ave SE: 7/23 (3 weeks)
* Concrete removals (curb and gutter, valley gutters, driveways, etc.)

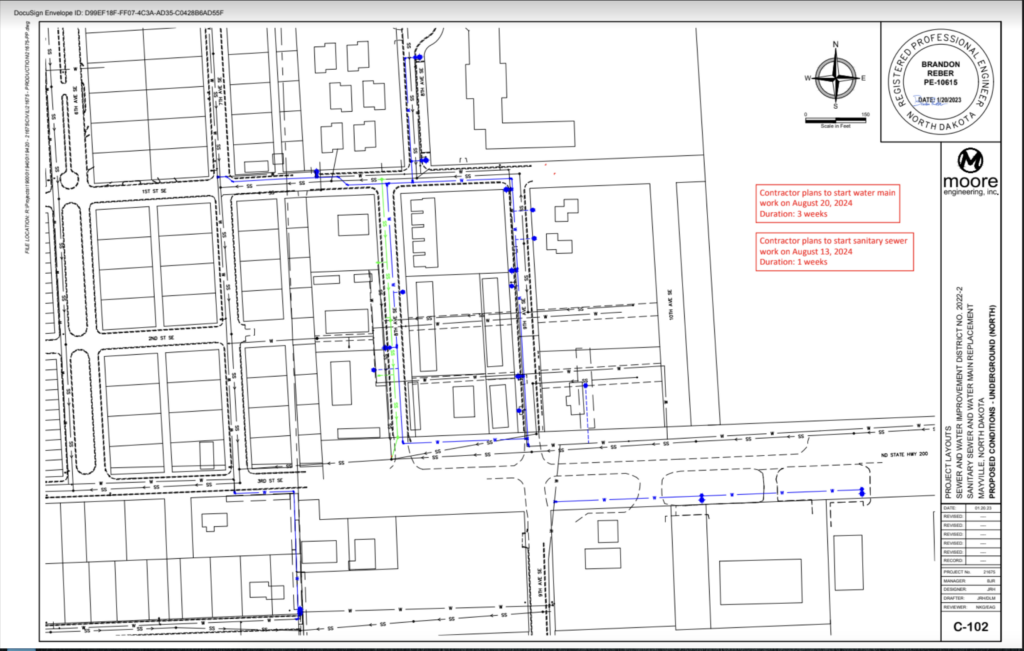

Water Main Replacement (North Hwy200)
* 1st St SE: 8/20 (3 weeks)
* 8th Ave SE: 8/20 (3 weeks)
* 9th Ave SE: 8/20 (3 weeks)
* 8th Ave SE (cul-de-sac): 8/20 (3 weeks)
* Concrete removals (curb and gutter, valley gutters, driveways, etc.)
Sanitary Sewer Main Replacement
* 8th Ave SE: 8/13 (1 week)
* Concrete removals (curb and gutter, valley gutters, driveways, etc.)
